Skip to main content
Activities by Resource

Overview

The Activities by Resource report bridges your schedule and your budget. It shows exactly which resources are assigned to which schedule activities, with cost data time-phased across the project timeline. This makes it easy to verify that every activity has resource coverage, identify misalignments between your schedule and your budget, and analyze how costs are distributed across the project timeline. URL: /Reporting/ActivitiesByResourceReport/Index

Prerequisites

  • Select a project. The report does not load until a project is selected.

Filters

The page header contains five inline filters. Selecting a project immediately loads the grid. Selecting a WBS reloads the grid and populates the Work Package dropdown. Selecting a Work Package reloads the grid scoped to that one work package.
FilterWhat It Controls
ProjectThe project to analyze. Required.
WBSLimit the report to a specific WBS element and its children. The dropdown includes a search box. Selecting a WBS also populates the Work Package dropdown.
Work PackageLimit to a specific work package within the selected WBS. The dropdown includes a search box.
ScaleToggle between Yearly and Monthly time-phased columns. Default: Yearly. Hidden for projects using a custom calendar; see below.
UnitDisplay values in base currency, thousands (K), or millions (M).

Custom Calendar Projects

For projects configured with a custom calendar, the Scale dropdown is replaced by a Calendar dropdown listing the project’s named calendars. Selecting a different calendar reloads the time-phased columns using that calendar’s period labels instead of fiscal year or month names.

View Modes

The report offers two modes, controlled by a Report Type selector:
ModeDescription
Time-PhasedShows individual resource result types as separate rows (labor hours, FTEs, travel costs, and other configured resource results) with costs time-phased by fiscal year or month
Resource AssignmentAggregates costs at the resource assignment level, showing total cost per assignment per period without breaking out individual resource result types
Switch between modes based on whether you need individual resource type detail or a higher-level cost summary.

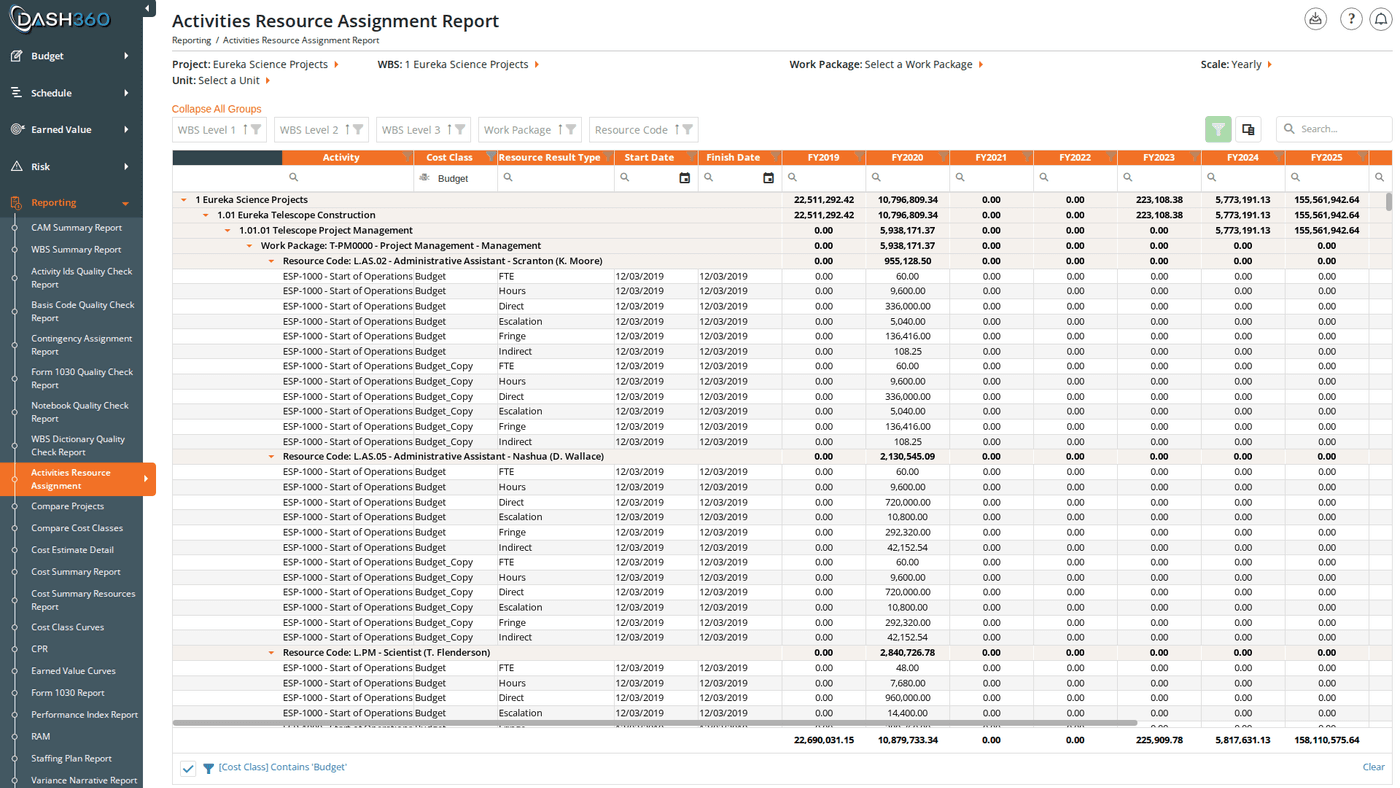

Reading the Grid

Hierarchy

The grid is organized hierarchically with group rows at each level:
WBS Level 1
  └── WBS Level 2
        └── WBS Level 3 (and deeper levels if configured)
              └── Work Package
                    └── Resource Code
Expand or collapse any group row by clicking it, or use the Expand All Groups / Collapse All Groups link above the grid. Each group row shows summed totals for every time-phased column and the Total column, so you can read roll-up costs at any level of the hierarchy without expanding.

Fixed Columns

These columns appear at the left side of the grid and remain visible while scrolling through time-phased columns:
ColumnDescription
WBS Level 1–3WBS group columns, visible by default. Additional WBS levels (4+) are available via the column chooser but hidden by default.
Work PackageWork package group column
Resource CodeResource code group column
Resource Assignment IDHidden by default. Can be added via the column chooser.
ActivityThe schedule activity name
Cost ClassThe cost class for this assignment. Default filter: Budget: only Budget cost class data appears on initial load.
Resource Result TypeThe type of resource result (e.g., Labor Hours, FTEs, Travel)
Start DateThe resource assignment start date
Finish DateThe resource assignment finish date
The Cost Class column has a default filter of Budget. If you need to see other cost classes (Revised, Actuals, etc.), clear or change the Cost Class filter in the filter row.

Time-Phased Columns

After the fixed columns, one column appears per fiscal year or calendar month (depending on the Scale setting), followed by a Total column. For custom calendar projects, columns use the calendar’s period labels. Column header styling:
  • Time-phased column headers have an orange background to visually distinguish them from the fixed identifier columns.
  • The cell in a data row whose column matches the current reporting period is highlighted in light orange; making the active period easy to locate when scrolling across many columns.
A grand total row at the bottom of the grid sums all visible data rows for each time-phased column.

When to Use This Report

Use Activities by Resource when you need to:
  • Verify coverage: Confirm that every schedule activity has at least one resource assignment.
  • Spot misalignments: Find activities where the resource assignment dates don’t match the scheduled activity dates.
  • Analyze cost distribution: Understand how costs spread across the project timeline at the activity level rather than the work package level.
  • Connect schedule and budget: Use alongside the Schedule Viewer to cross-reference activity timing against resource costs.

Saved Views

Activities by Resource supports named saved views that preserve your column layout, grouping, and filter settings. Use the view selector in the toolbar to save and reload your own named views.
When viewing a system view, the message “Currently viewing a system view. Changes will not be saved.” appears at the top right of the grid.

Grid Features

FeatureDescription
Expand/Collapse All GroupsLink above the grid. Toggles all group rows at once.
Column chooserAdd hidden columns: WBS Level 4+, Resource Assignment ID, and others.
Search panelFree-text search across all visible columns
Filter rowPer-column filter inputs; click Apply Filters to apply
Header filterClick any column header for value-based filtering
Filter panelShows active filter criteria and allows clearing them
Group panelDrag columns to add additional grouping levels
Context menuRight-click a group row to expand or collapse it individually

Exporting

Click the Download icon and select Export as Excel. The file is saved as ActivitiesByResourceReport.xlsx with the grid data on a sheet named ActivityByRA.
