Skip to main content
Quick Status

Overview

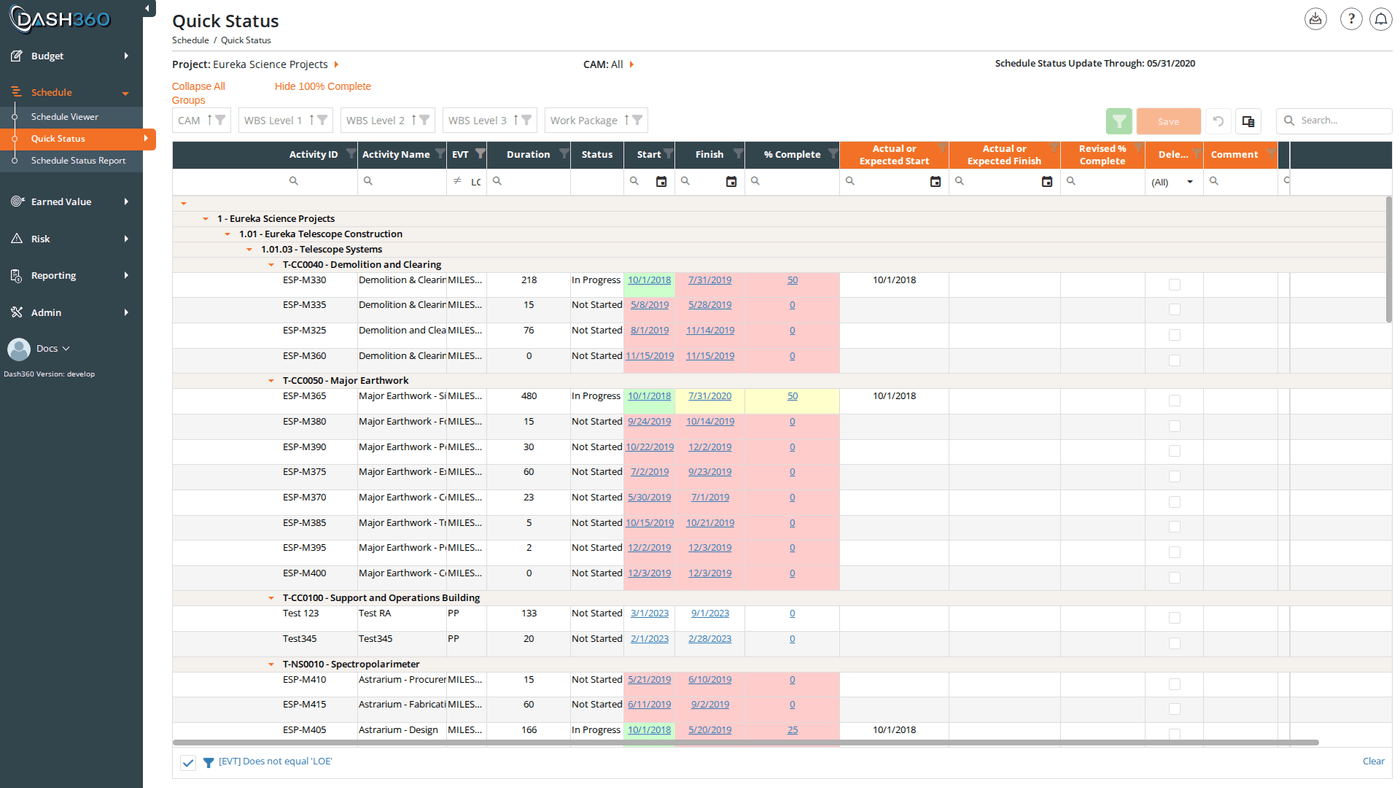

Quick Status is the primary way Control Account Managers submit schedule updates. It displays activities assigned to your work packages with color-coded status indicators, and lets you enter revised dates and percent complete directly in the grid. When you are done, you save your changes and submit them to your administrator for review and approval. Once approved, those changes are written back into the live schedule. URL: /Schedule/QuickStatus/Index

Prerequisites

  • Select a project and CAM from the inline filters in the page header.
  • You must have Schedule access for at least one work package in the selected project.

Page Layout

The page header contains two inline filters: Project and CAM. Once a CAM is selected, the Schedule Status Update Through: [date] label appears in the header, showing the cut-off date for this update cycle. Above the grid, two quick-action links are available:
  • Expand All Groups / Collapse All Groups: toggles all WBS group rows at once
  • Hide 100% Complete / Show 100% Complete: hides or shows activities already at 100%

Reading the Grid

Grouping

Activities are grouped by CAM, then WBS Level 1, WBS Level 2, and WBS Level 3 by default, then by Work Package. Expand or collapse groups by clicking the group row or using the Expand/Collapse link above the grid.

Default Filter

On first load with a system view, Level of Effort (LOE) activities are automatically filtered out. Only measurable activities requiring status updates are shown.

Color-Coded Cells

Three read-only columns use background color to signal status at a glance: Start column:
ColorMeaning
RedActivity was scheduled to start, but % Complete is still 0; it hasn’t started
GreenActivity has started (% Complete > 0 and status date ≥ scheduled start)
No colorActivity is not yet due to start
Finish column:
ColorMeaning
GreenActivity is 100% complete
YellowActivity is in progress and scheduled to finish in the current status period
RedActivity is overdue: less than 100% complete but finish date has passed the status date
No colorActivity has not yet reached its finish period
% Complete column:
ColorMeaning
Green100% complete
YellowIn progress (>0% and <100%)
RedOverdue: less than 100% complete but finish date is past the status date
No colorNot yet started

Columns

Editable columns (shown with an orange column header):
ColumnWhat to Enter
Actual or Expected StartThe actual start date if the activity has started, or the expected start date if it hasn’t yet
Actual or Expected FinishThe actual finish date if complete, or the expected finish date
Revised % CompleteCurrent percent complete (0–100). Read-only if the activity has Activity Steps; percent is driven by step completion instead
DeleteCheck this box to flag the activity for deletion from the schedule. Checking it strikes through the row and clears the Actual/Expected fields
CommentNotes for the administrator explaining your changes
Read-only columns (for reference):
ColumnDescription
Activity IDThe activity’s identifier in the schedule
Activity NameActivity description
EVTEarned Value Technique for the activity
DurationCurrent scheduled duration
StatusCalculated: Not Started / In Progress / Complete based on % complete and status date
StartOriginally scheduled start date
FinishOriginally scheduled finish date
% CompleteCurrent percent complete from the last approved update
Revised DurationDuration as revised
Work PackageWork package the activity belongs to
Hidden columns (available via the column chooser): WBS Level 1–9, WBS Number, WBS Description, Work Package Number, Work Package Description, # of Activity Steps, Work Package Weight, custom fields, and notebook category columns.

Entering Status Updates

Quick-Entry Shortcuts

Clicking the read-only Start cell copies the scheduled start date directly into Actual or Expected Start, giving you a starting point to edit. The same applies to the Finish cell → Actual or Expected Finish, and % CompleteRevised % Complete. This saves typing when the scheduled date is close to the actual date.

Auto-Populate on 100% Complete

When you enter 100 in Revised % Complete and move to the next cell, the grid automatically fills in the Actual Start and Actual Finish dates from the scheduled dates if those fields are empty.

Fill Down (Ctrl + Drag)

To apply the same value to multiple consecutive rows:
  1. Hold Ctrl. Small triangle handles appear in the lower-right corner of each editable cell.
  2. Click and drag the triangle handle downward across the rows you want to fill.
  3. Release to apply the value from the starting cell to all rows in the dragged range.
This is useful for quickly setting the same date or percent complete across a group of related activities.

Marking an Activity for Deletion

Check the Delete checkbox on any row to flag that activity for deletion from the schedule. The row displays with strikethrough text and the Actual/Expected date fields are cleared. The deletion is part of the submission and takes effect only after administrator approval.

Activity Steps

If Activity Steps are enabled for the project, a Steps button appears in the row actions column. Click it to open the Activity Steps modal for that activity.

Activity Steps Modal

The modal shows two sets of columns side by side; the current baseline values (read-only) and the revised values you can edit: Read-only (baseline):
ColumnDescription
Step IDThe step identifier
Step DescriptionDescription of the step
WeightThe step’s weight used to calculate overall % complete
% CompleteCurrent completion percentage for this step
Editable:
ColumnDescription
Revised Step IDUpdated step identifier
Revised Step DescriptionUpdated description
Revised WeightUpdated weight
Revised % CompleteYour updated completion percentage for this step
Clicking a read-only cell copies its value into the corresponding Revised field for quick editing. Adding a step: Click Add Row to insert a new step. Fill in the Revised Step ID, Revised Step Description, Revised Weight, and Revised % Complete for the new step. Deleting a step: Check the delete option on a step row. The step displays with strikethrough text. Step percentages and weights roll up to calculate the activity’s overall Revised % Complete on the main grid.

Validation Rules

Dash360 enforces validation rules when you save. If any rule is violated, an error message appears and no data is saved until all errors are corrected. Columns with errors display a red outline with an orange background. The rules are configurable by your administrator (some may be turned off for your project). Key rules include:
SituationWhat is Required
Activity already had a % complete in a prior periodRevised Start must be provided
Activity was scheduled to start this month or earlierRevised Start must be provided
Activity already had a % complete in a prior periodRevised Finish must be provided
Activity was scheduled to start or finish this periodRevised Finish must be provided
Actual Finish date enteredMust be on or after the Actual Start date
Actual Finish is before the status dateRevised % Complete must be 100%
Actual Start is after the status dateRevised % Complete must be 0%
Revised % Complete is 100%Actual Finish must not be after the status date
All date fieldsYear must be 2000 or later
If a rule fires, a message describes exactly what is required. Contact your administrator if a rule prevents a valid update; rules can be adjusted in Admin > Quick Status Rules.

Saving and Submitting

When your updates are complete, click Save in the grid toolbar.

Auto-Send (if enabled)

If the project is configured for automatic submission, your changes are immediately sent to the administrator without any further steps. A success message confirms they have been sent.

Review and Send to Admin (standard flow)

If auto-send is not enabled, the Send Quick Status to Admin for Approval modal opens. It shows all of your pending updates in a review grid with the following columns:
ColumnDescription
Updated ByUser who entered the update
WBS / WBS NameWBS element for the activity
Activity ID / DescriptionThe activity being updated
Activity DurationScheduled duration
Start / FinishOriginal scheduled dates
% CompleteCurrent percent complete
Actual or Expected StartYour revised start date
Actual or Expected FinishYour revised finish date
Revised % CompleteYour revised % complete
Delete ActivityWhether the activity is flagged for deletion
CommentsYour comment
Work Package / NameWork package the activity belongs to
Added / Removed PredecessorsDependency changes
Added / Removed SuccessorsDependency changes
Schedule Status DateThe cut-off date for this update
Last UpdatedWhen this update was last modified
Sent to AdminWhether this update has already been submitted
ApprovedWhether this update has been approved
You can delete individual entries from the modal grid before sending if you change your mind about a specific activity. Click Send to Admin to submit all listed updates. The updates are sent to Schedule > Schedule Status Updates where your administrator reviews and approves them.
Submitted changes do not appear in the live schedule until an administrator approves them in Schedule Status Updates.

Withdrawing a Pending Update

If you need to withdraw an update that has been submitted but not yet approved, locate the row in Quick Status and click Delete Status in the row actions. This removes the pending submission. You can then re-enter corrected values and resubmit. If the deletion was accidental, click Restore Status to bring the pending update back.

Saved Views

Quick Status supports named saved views that preserve your column layout, grouping, filters, and sort settings. A System View loads by default.
When viewing a system view, the message “Currently viewing a system view. Changes will not be saved.” appears at the top right of the grid.

Grid Features

FeatureDescription
Expand/Collapse All GroupsLink above grid. Toggles all group rows at once.
Hide/Show 100% CompleteLink above grid. Filters out or shows back all activities at 100%.
Column chooserAdd hidden columns: WBS levels, custom fields, notebook categories, Work Package Weight.
Search panelFree-text search across all visible columns
Filter rowPer-column filter inputs; click Apply Filters to apply
Header filterClick any column header for value-based filtering
Filter panelShows active filter criteria and allows clearing them
Group panelDrag columns to add additional grouping levels
Context menuRight-click a group row to expand or collapse it individually

Exporting

Click the Download icon and select Export to Excel to download the current grid view to Excel.
