Overview
The Risk Register is the central workspace for identifying and managing project risks. It tracks each risk’s probability, cost and schedule impact, mitigation plans, and status throughout the project lifecycle. The register is organized into four collapsible sections: the main risk grid, heatmaps, Monte Carlo simulations, and burn down charts. URL:/Risk/RiskRegister/Index
Prerequisites
- A project must be selected to view the Risk Register.
- To add or edit risks, your account must have Full Access to the Risk module for the selected project. Accounts with Read-Only access can view risks but cannot make changes.
- Risk ID Prefixes must be configured before adding risks. An administrator sets these up in Admin > Projects > Edit Project. Examples:
PR-,SED-,RISK-. - Risk thresholds (Cost, Probability, and Schedule) must be configured for the project before the Add/Edit modal can be opened. If thresholds are missing, an error message appears and the modal does not open.

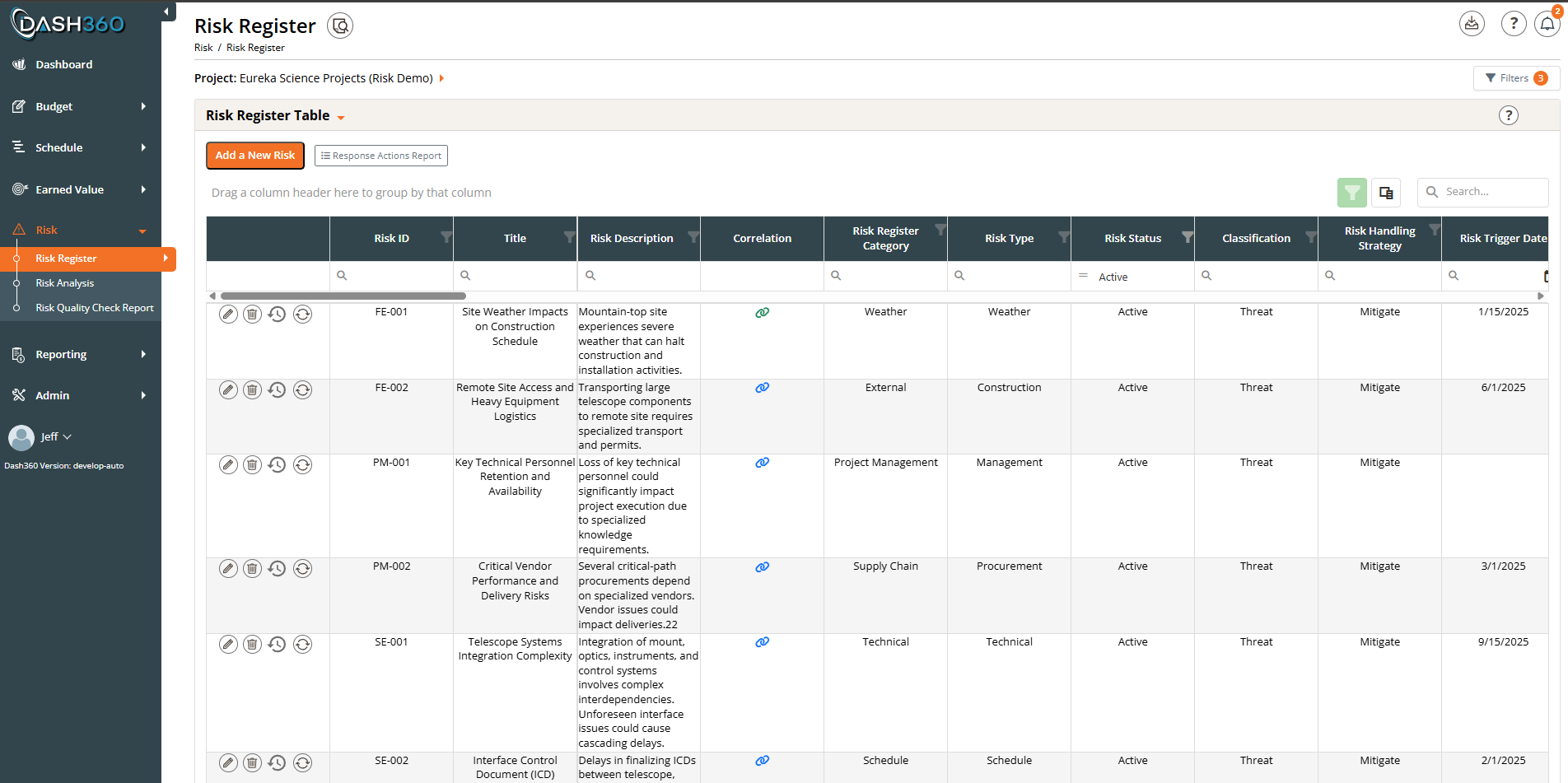

Risk Register Table

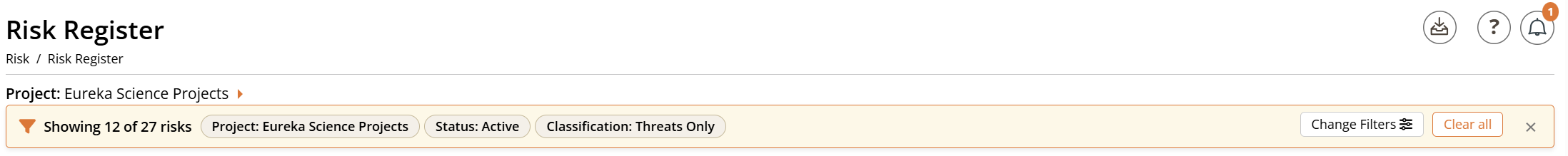

Status Filter
A Status multi-select dropdown appears above the grid. You can select one or more statuses to show simultaneously. The default is Active only. Changing the status filter also updates the heatmaps in the Risk Register Heatmaps section to match. Available status values:Grid Columns
Row Actions
Each row has four action buttons:Toolbar Controls

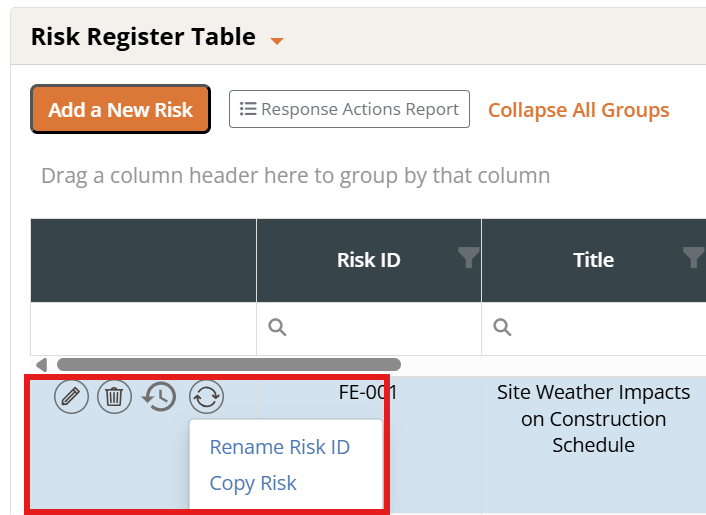

Above the grid:- Add a New Risk: opens the Add/Edit modal to create a new risk
- Expand All Groups / Collapse All Groups: toggles all grouped rows
- Clear All Filters: removes all active grid filters
Add or Edit a Risk
Click Add a New Risk in the toolbar, or click the Edit icon on any existing risk row. Both open the Add/Edit Risk modal, which contains four collapsible sections.Validation
The following fields are required. Saving without them shows an error and the modal does not close:- Risk ID Prefix (add only)
- Title
- Risk Category
- Risk Type
- Cost Impact
- Probability
- Schedule Impact

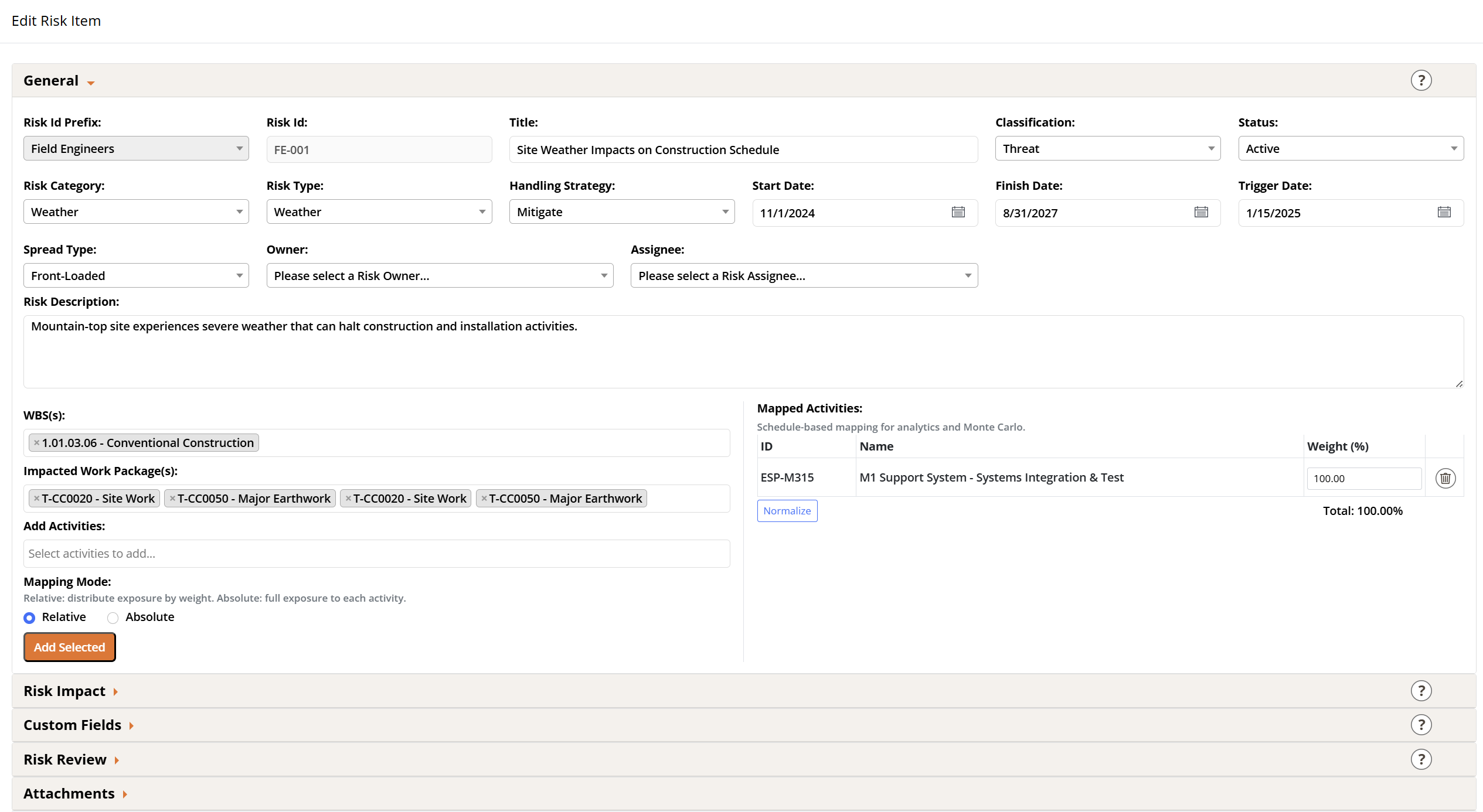

General Section
Risk IDs are assigned sequentially at save time and cannot be manually entered on a new risk. The Risk ID and Risk ID Prefix fields are locked (disabled) when editing an existing risk. To change a Risk ID, use Rename Risk ID from the process icon menu.

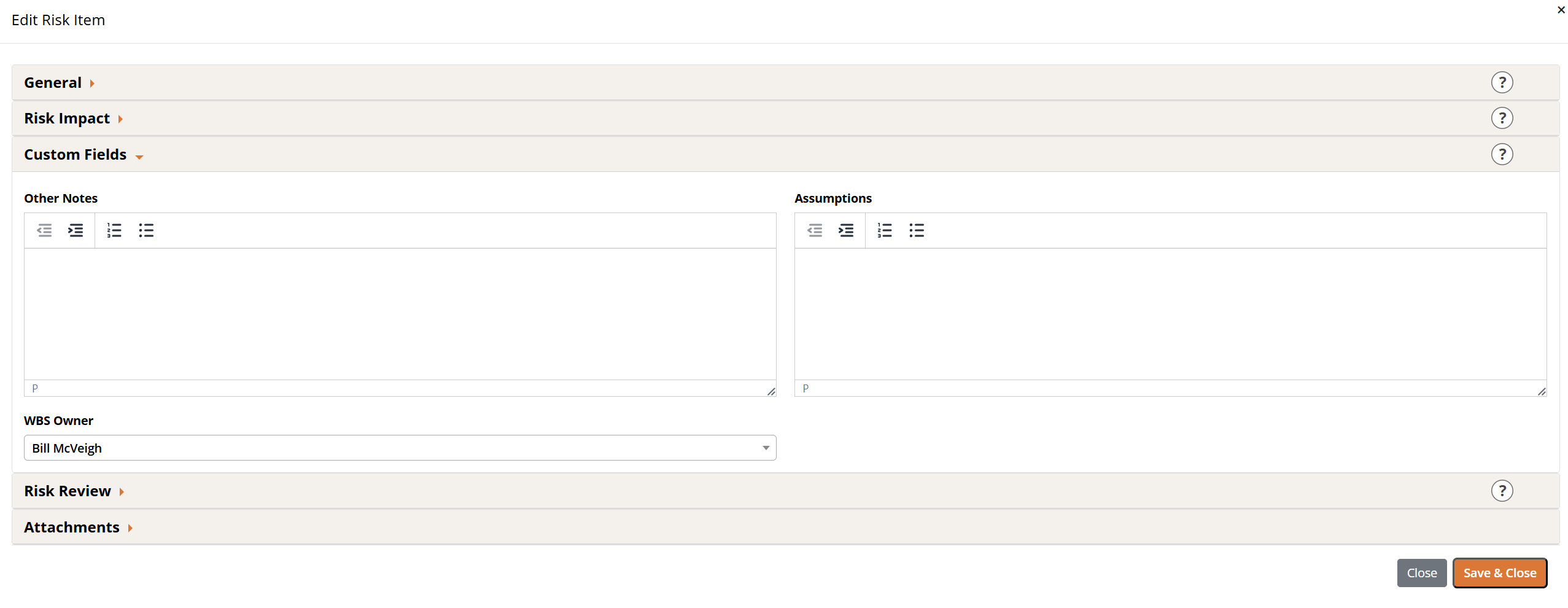

Notebook Fields Section
Contains custom fields configured for your project’s risk register. Field types include text, textarea, rich text (WYSIWYG), date, radio buttons, checkboxes, dropdown, code file, and CAM. This section is empty if no notebook fields have been configured.Mitigations & Timeline Section

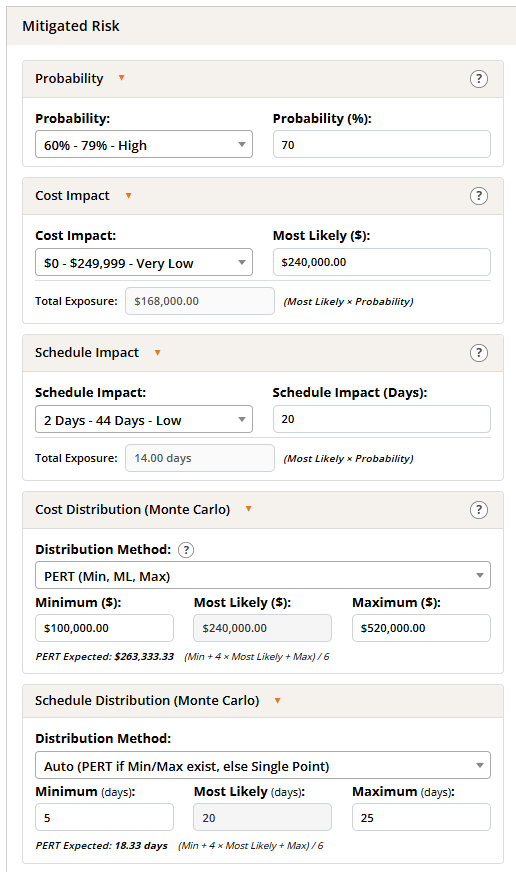

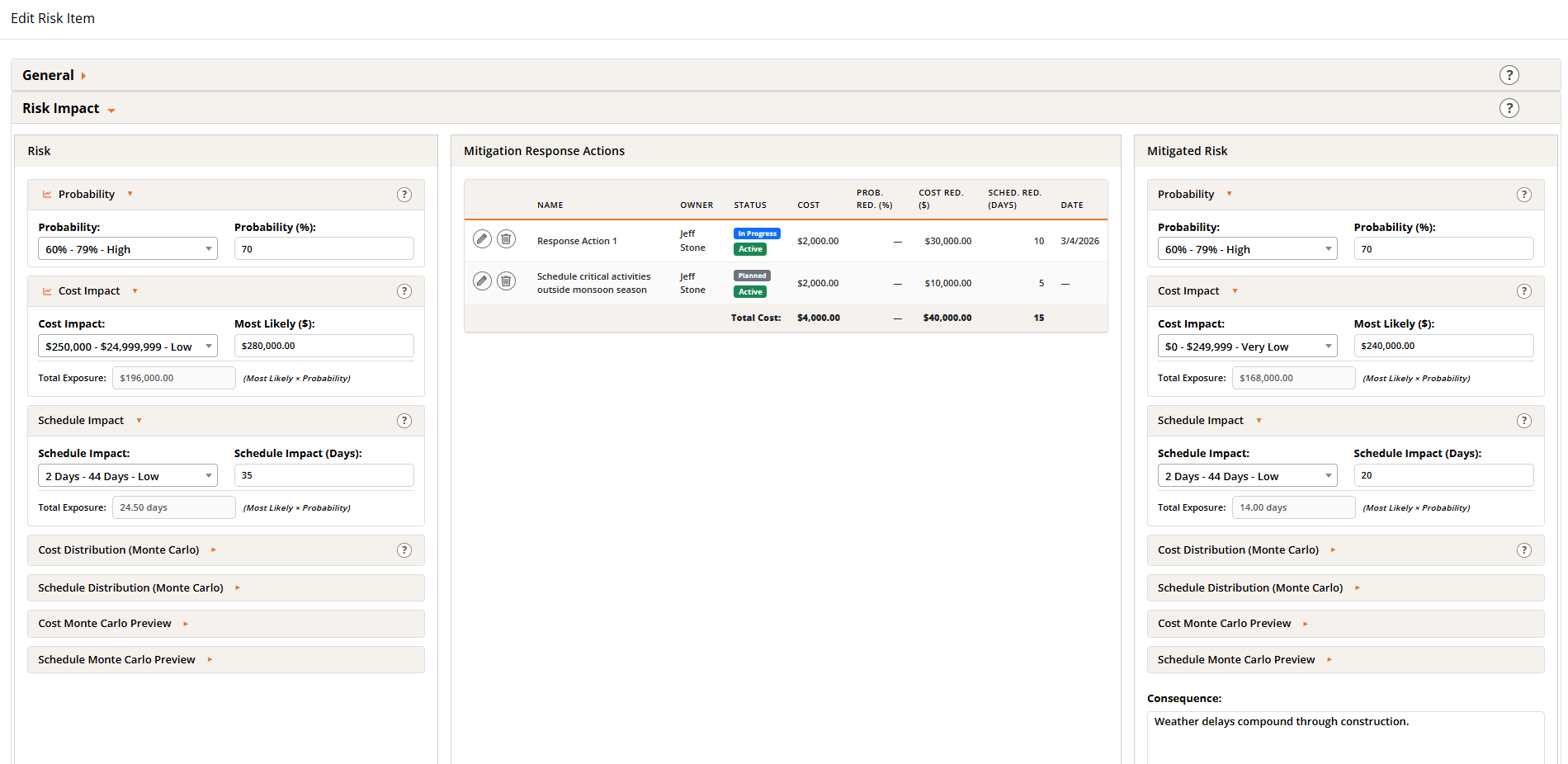

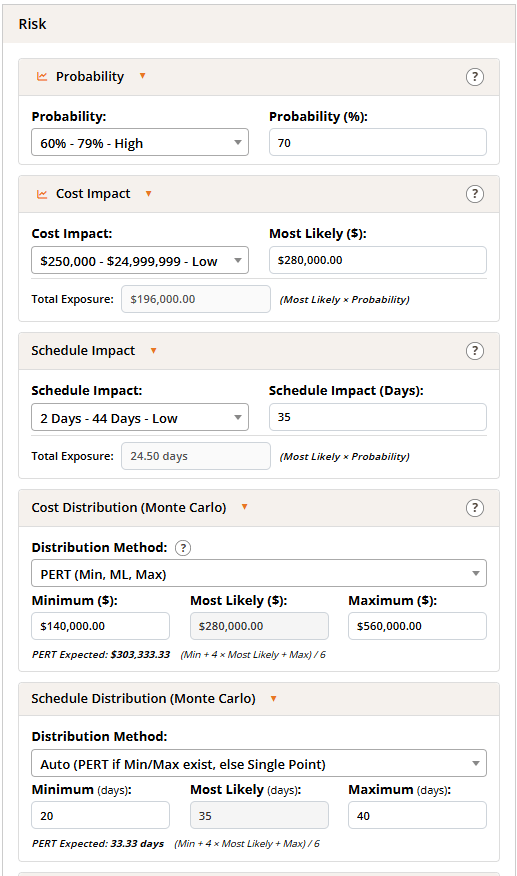

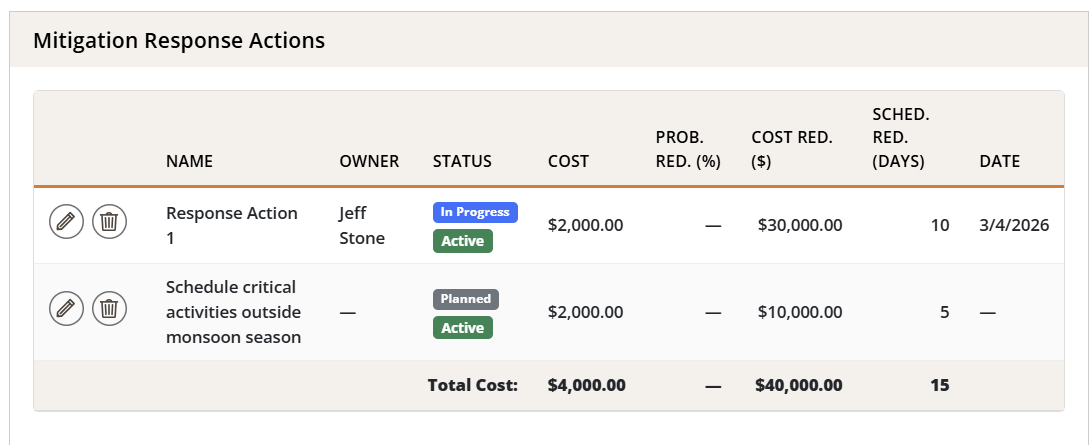

Risk Impact Section
This section uses threshold dropdowns as a quick-entry aid: selecting a threshold range from the dropdown automatically fills the corresponding numeric field with the threshold’s boundary value. You can always override the auto-filled value manually.Save Options
- Save & Close: saves the risk and closes the modal
- Save & Add Another: saves the risk, resets the form, and keeps the modal open (only available when adding a new risk, hidden when editing)

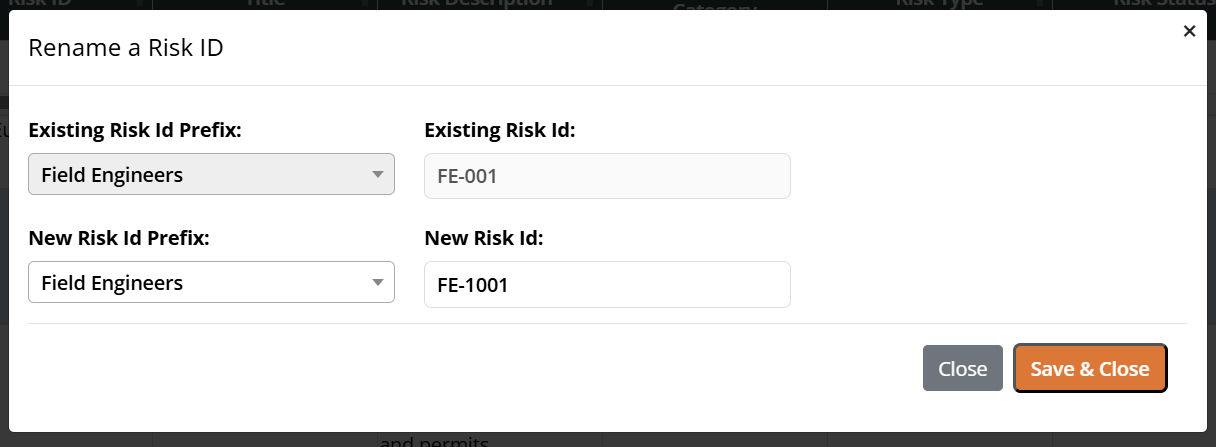

Rename a Risk ID
To assign a risk a different ID without losing any associated data:- Click the process icon (gear icon) on the risk row.
- Select Rename Risk ID.
- In the modal, the Existing Risk ID Prefix and Existing Risk ID are shown as read-only.
- Select a New Risk ID Prefix: the New Risk ID field auto-populates with the next sequential ID for that prefix.
- Optionally edit the New Risk ID manually.
- Click Save & Close.

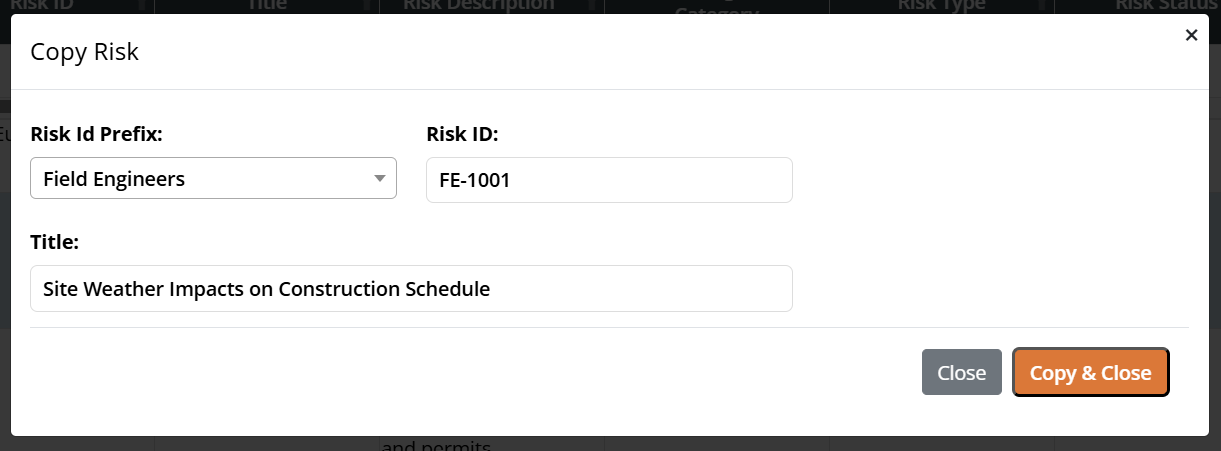

Copy a Risk
To create a new risk based on an existing one:- Click the process icon (gear icon) on the risk row.
- Select Copy Risk.
- In the modal:
- Select a Risk ID Prefix for the new risk; the Risk ID field auto-populates.
- Enter a Title for the new risk.
- Click Copy & Close.
Delete a Risk

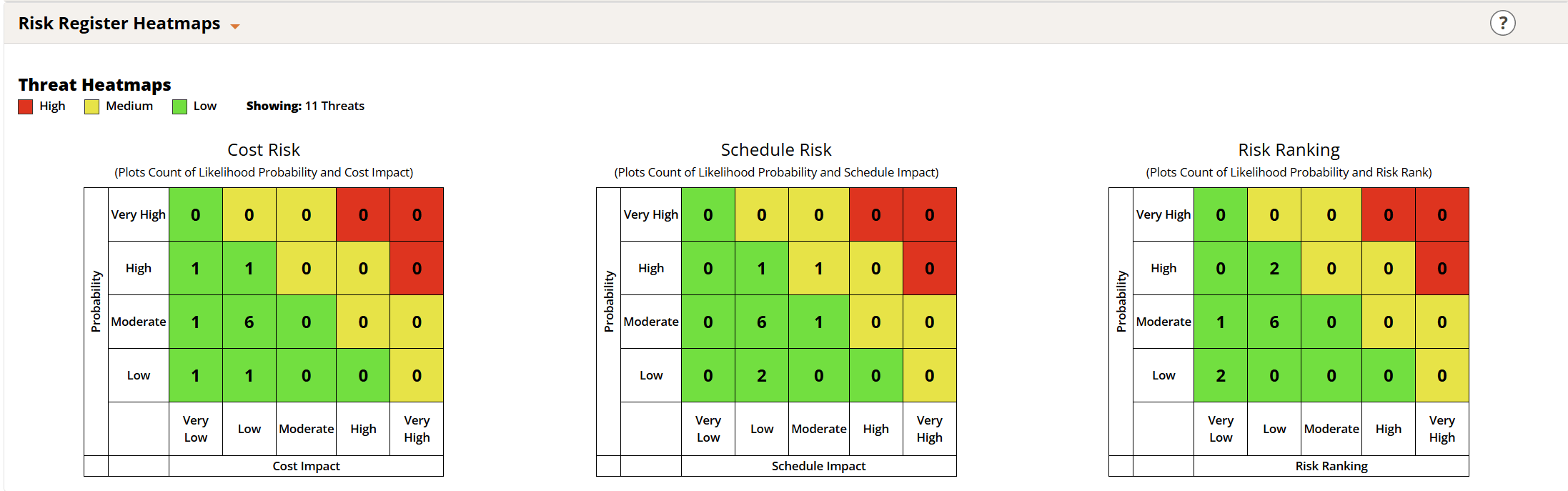

Click the Delete icon on the risk row and confirm.Risk Register Heatmaps

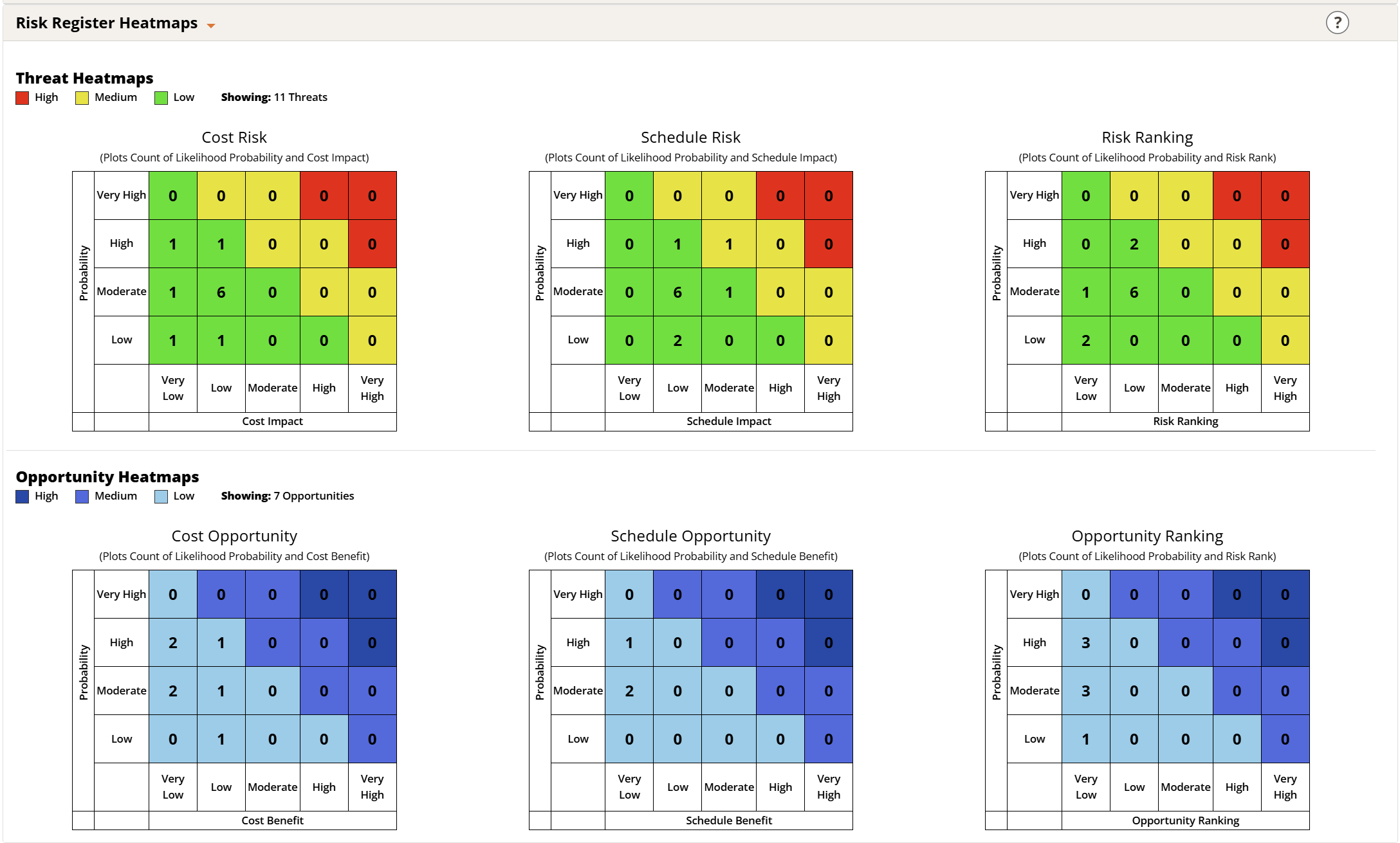

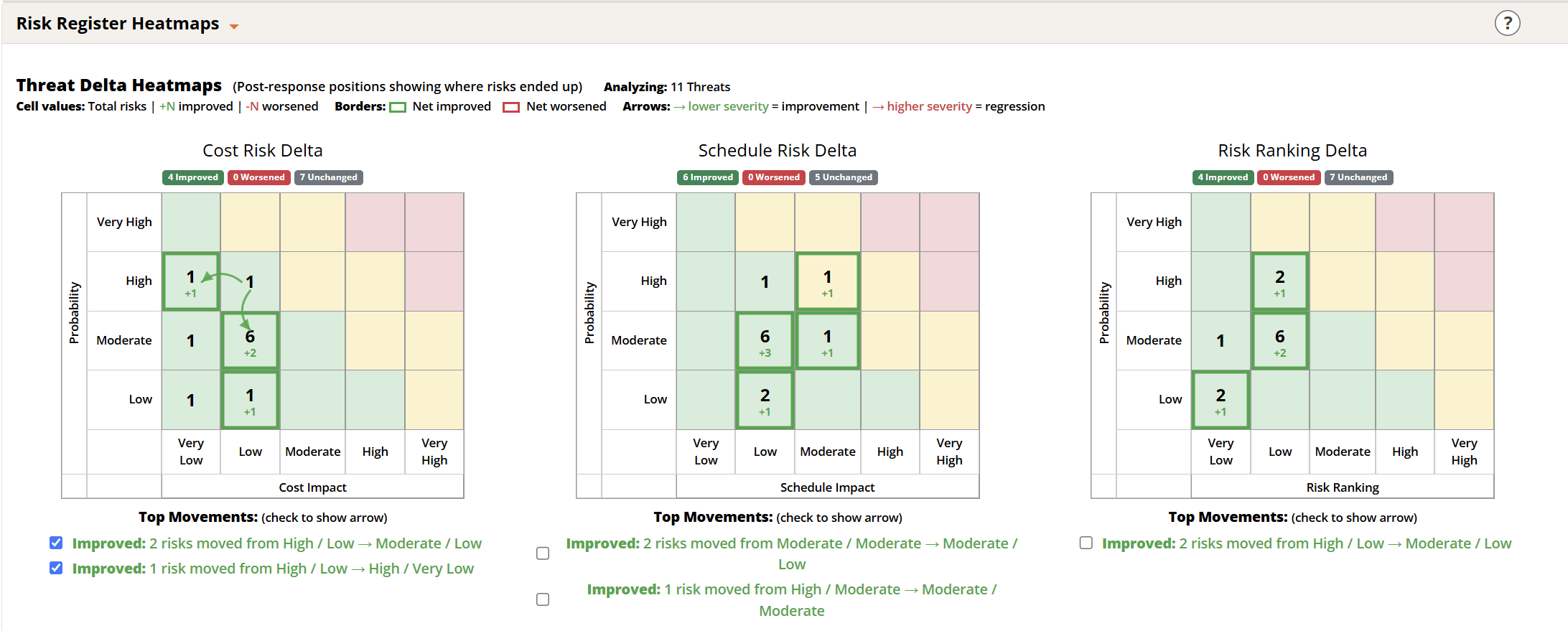

Click the Risk Register Heatmaps accordion to expand it. The section renders three heatmaps side by side, each plotting Probability on one axis against a risk dimension on the other axis:
Each cell shows the count of risks falling in that probability/impact range. Cells are color-coded:
- Green: low combined exposure
- Yellow: moderate combined exposure
- Red: high combined exposure
If risk thresholds have not been configured for the project, the heatmaps display a message prompting your administrator to complete the threshold setup.

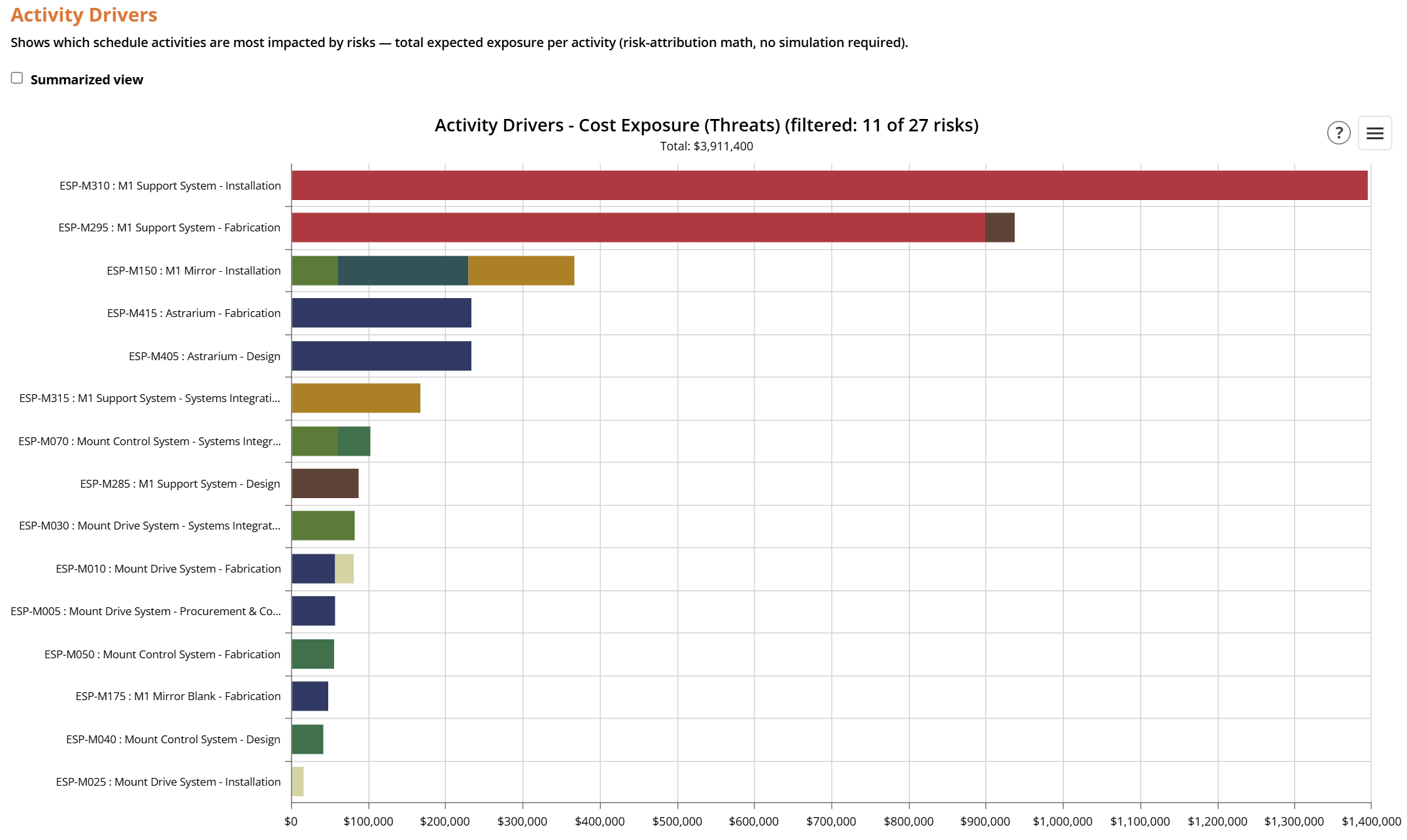

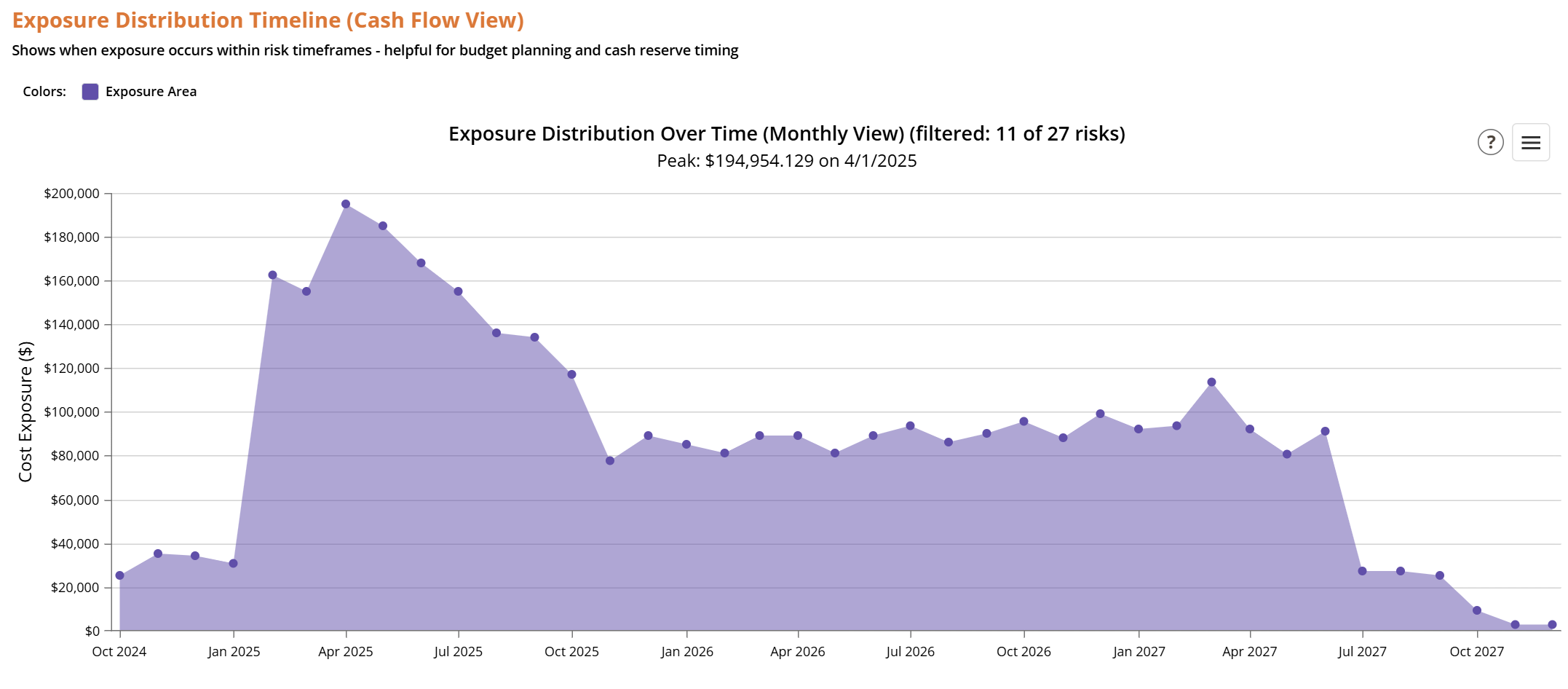

Risk Register Monte Carlo Simulations

Expand the Risk Register Monte Carlo Simulations accordion. This section is only shown when there is at least one risk in the project.Running a Simulation
- Set Simulation Iterations: the number of times to simulate the portfolio (must be between 10 and 50,000; default is 1,000).
- Click Run Monte Carlo simulation.

- A spline chart appears showing the cumulative cost distribution across all iterations. The x-axis is the simulation iteration index (0–1,000 by default); the y-axis is the total risk cost in dollars. Hover a point to see the dollar value.
Saving a Simulation
After running, a Simulation Title field and Save Simulation button appear below the chart.- Enter a title for this simulation run.
- Click Save Simulation.
Viewing Previous Simulations

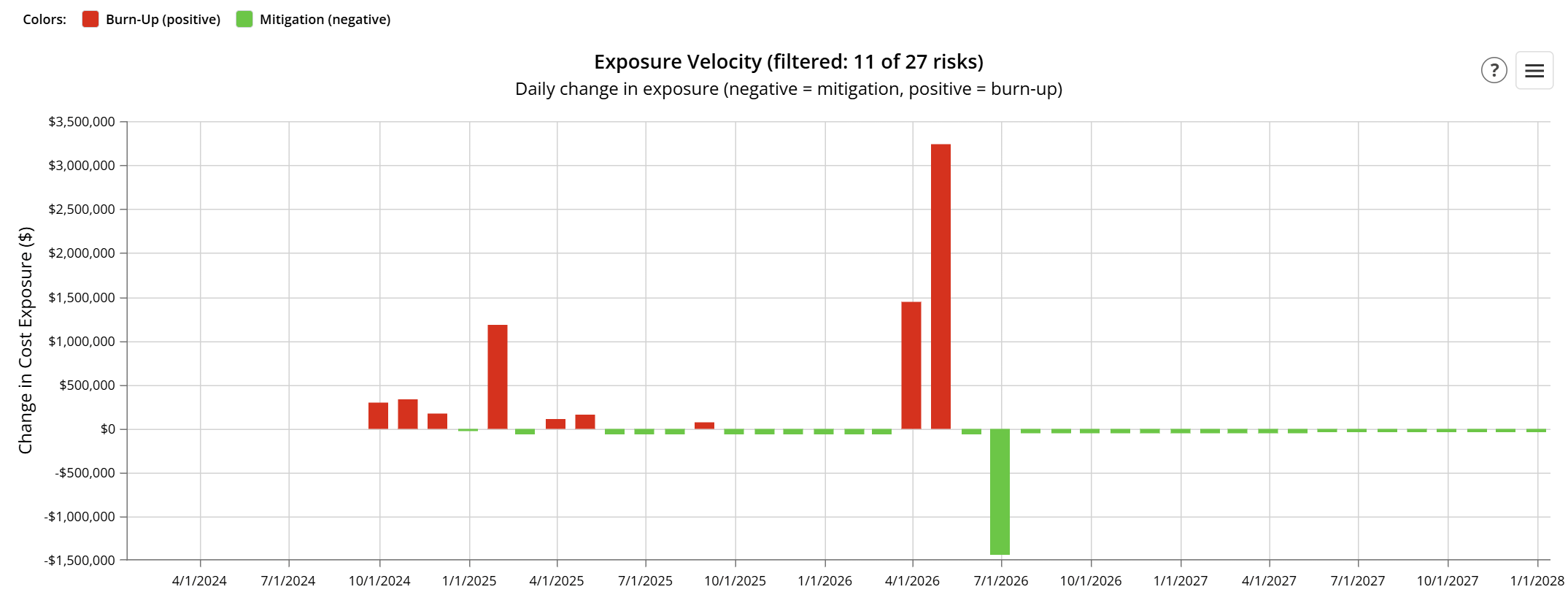

If saved simulations exist, a Previous Simulations dropdown appears at the top of the section. Select any saved simulation from the dropdown to reload its chart.Risk Register Burn Down Charts
Expand the Risk Register Burn down charts accordion to see how risk exposure has changed over time.This section is hidden for projects configured to hide burn down charts.

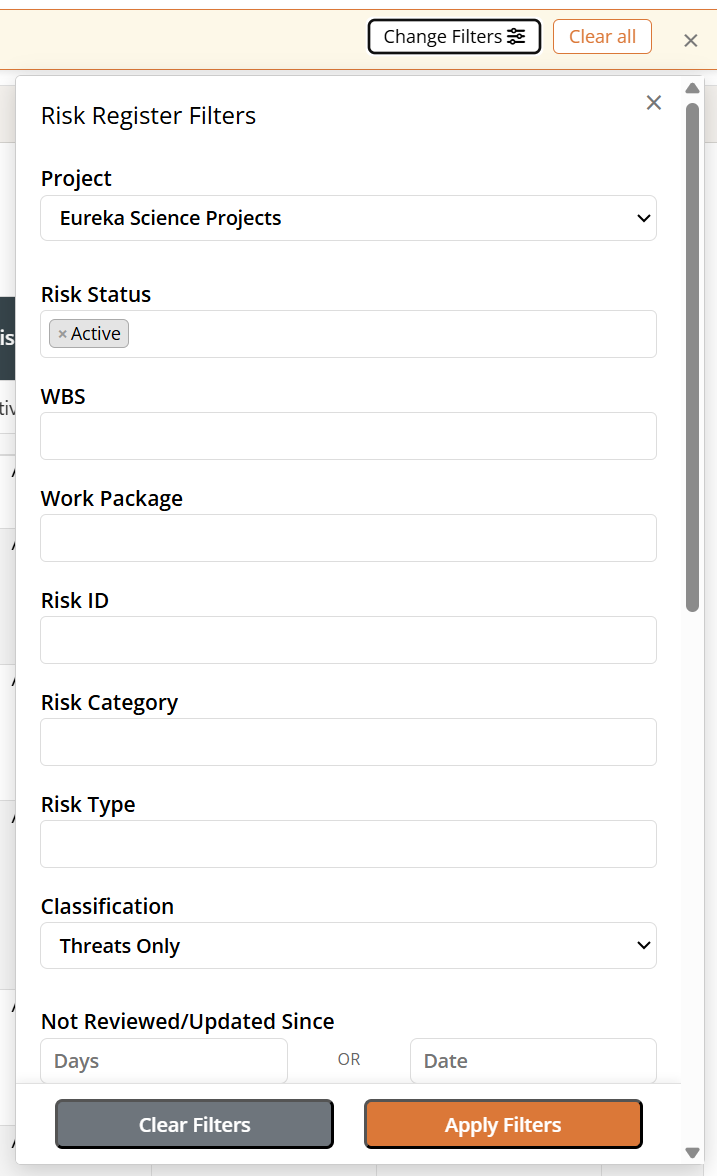

Burn Down Filters
Changing any filter refreshes the charts automatically.

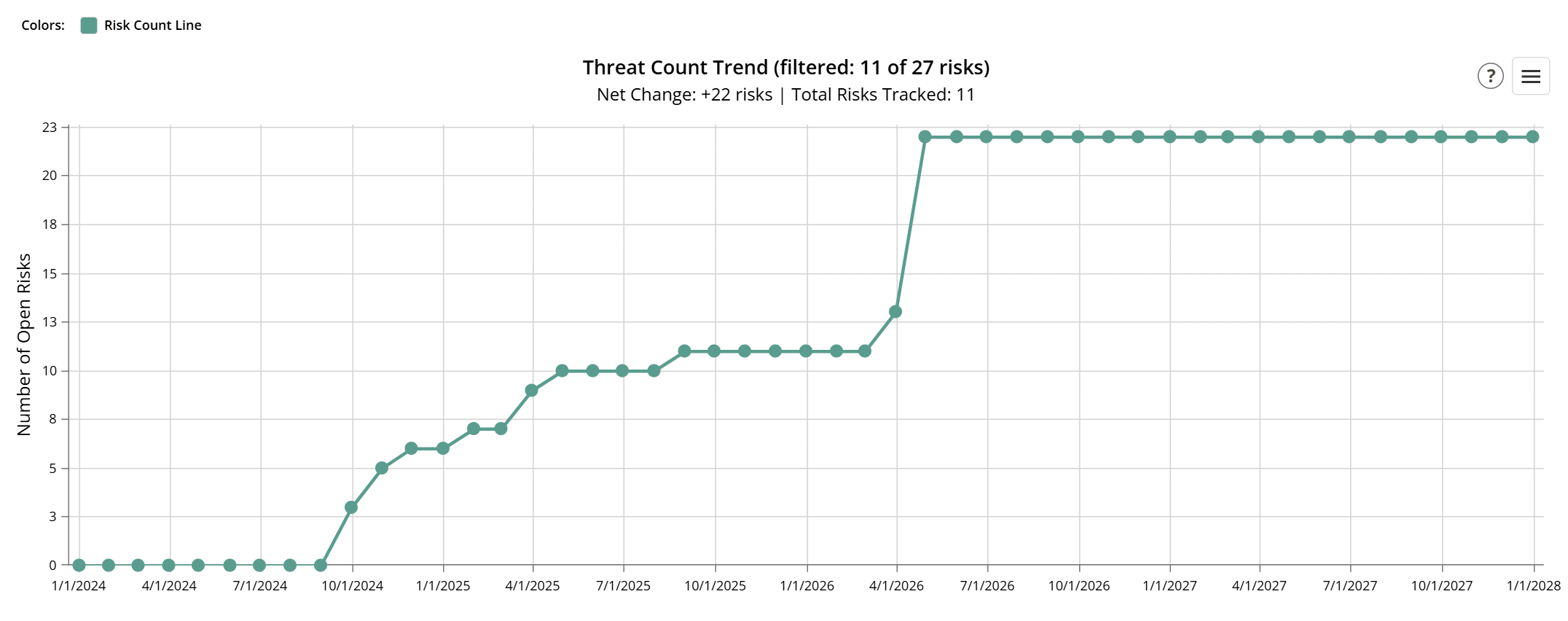

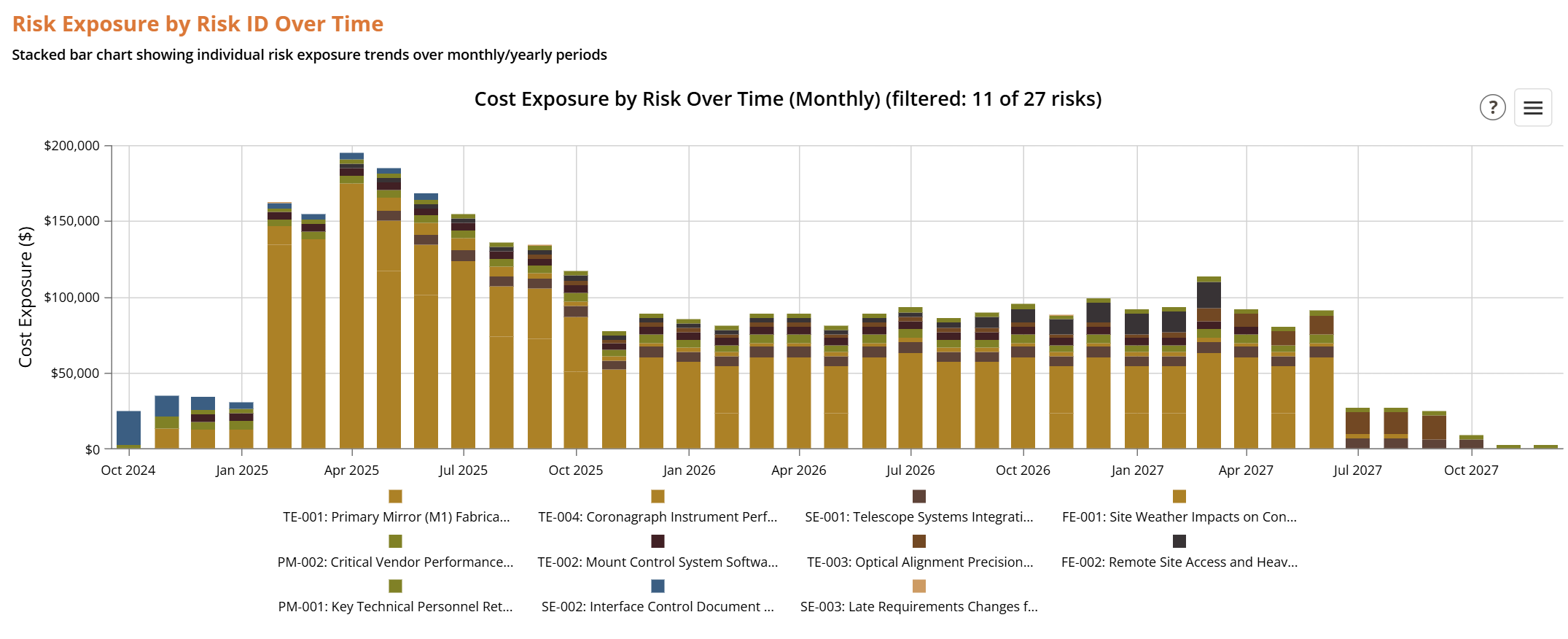

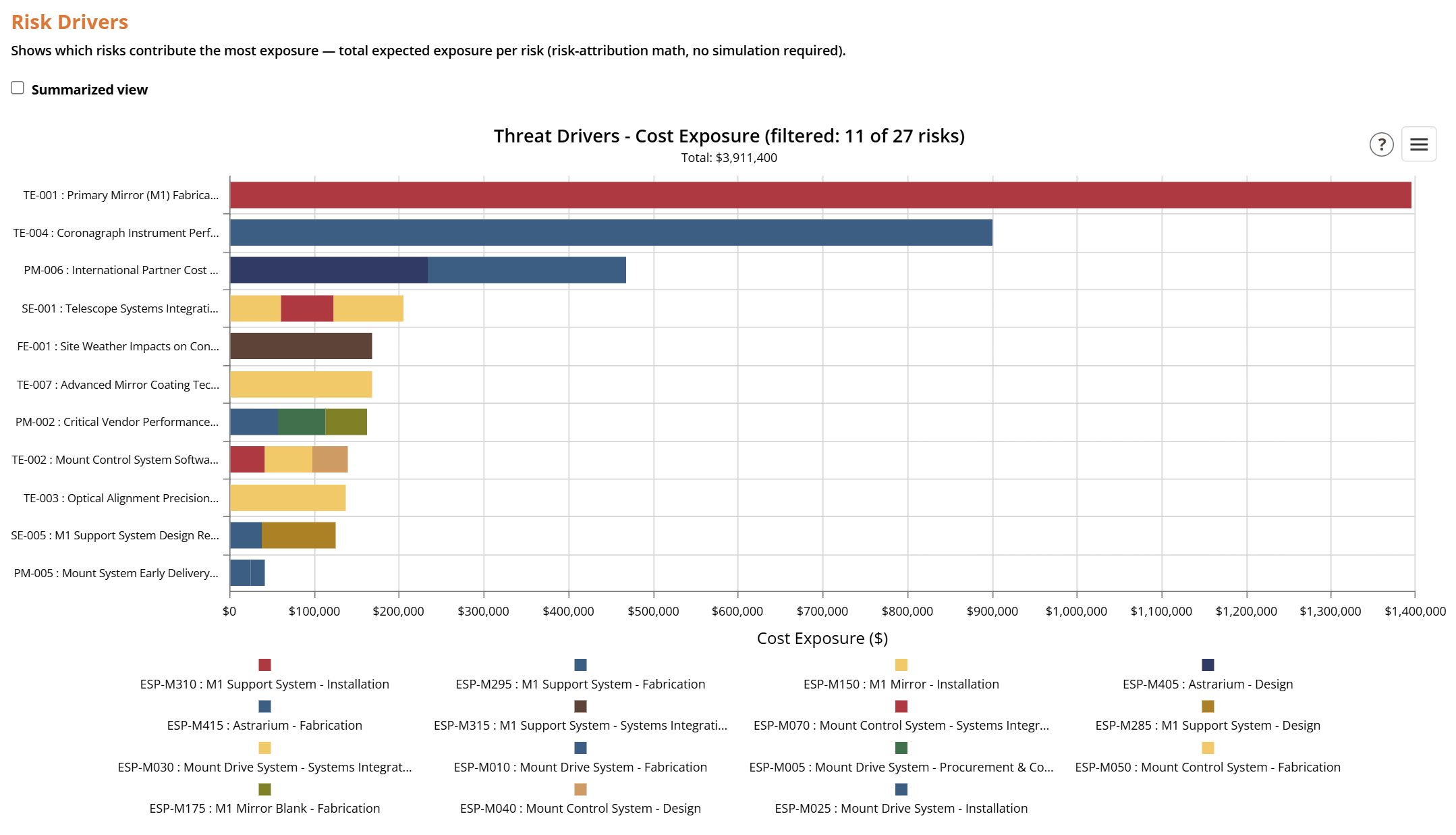

Charts

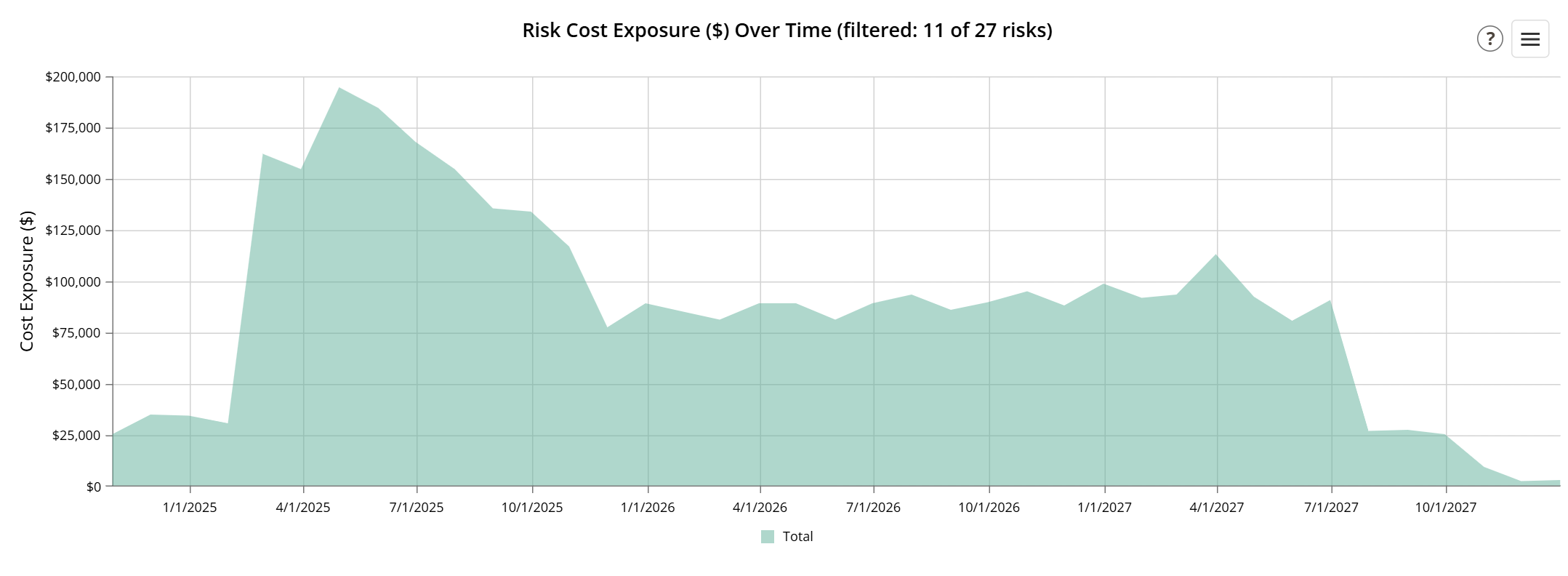

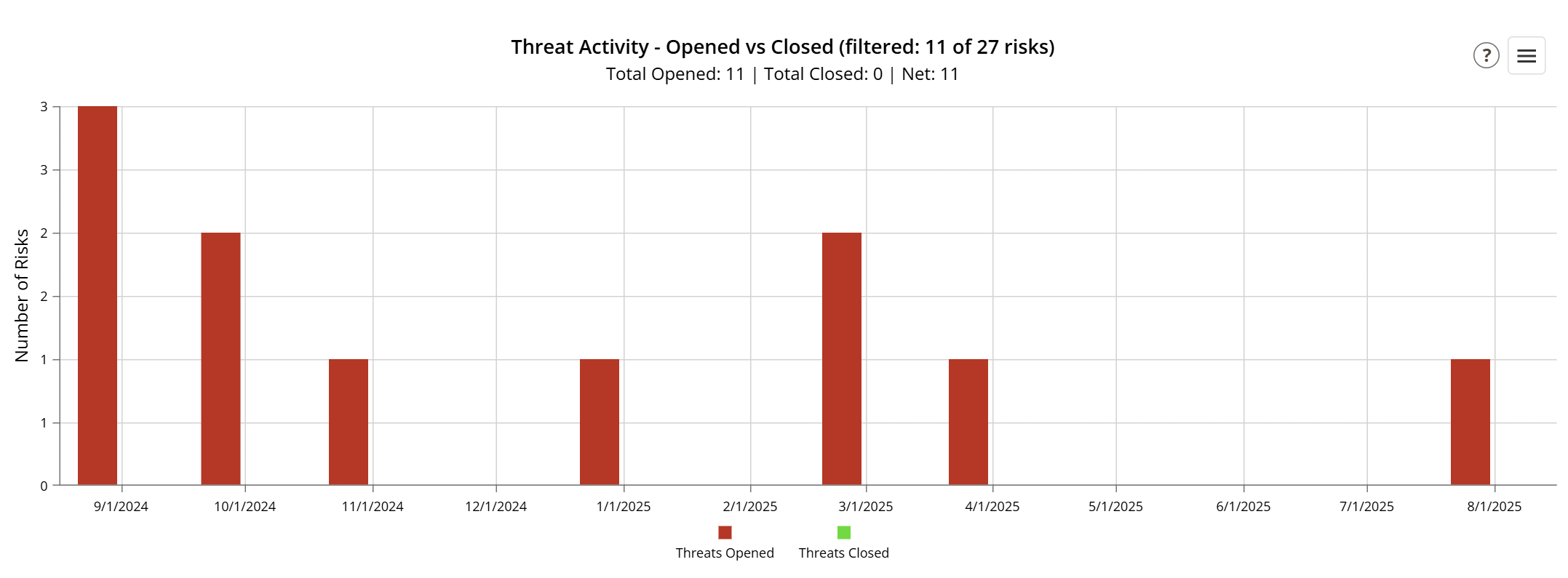

Two charts are displayed:- Cost Burn Down: total risk cost exposure over time
- Schedule Burn Down: total schedule impact exposure over time
Saved Views
The Risk Register supports named saved views that preserve your column layout, grouping, filters, and sort settings.When viewing a system view, changes to the grid layout are not saved. Switch to a user view to save your preferences.
Grid Features
Exporting

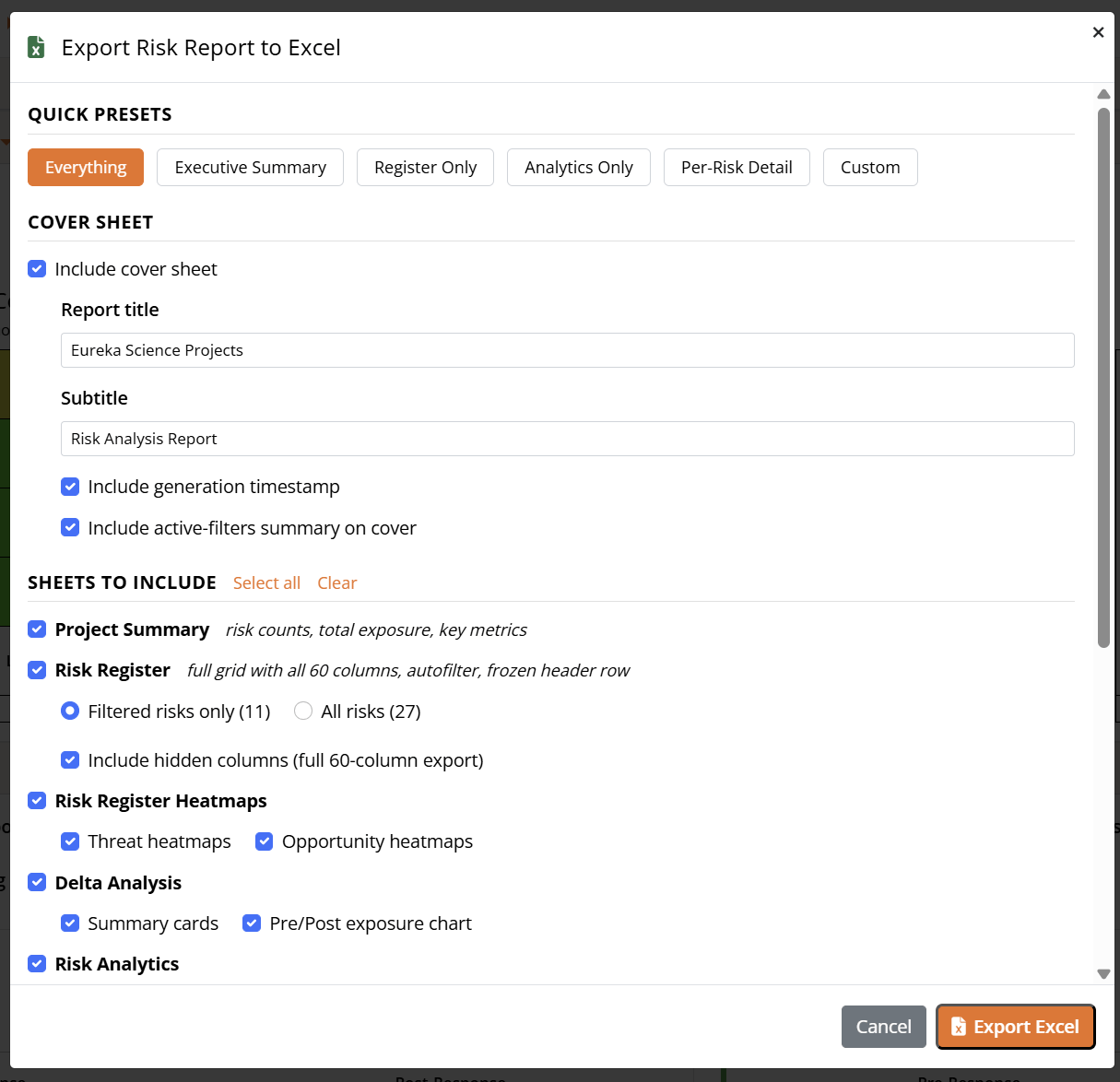

Click the Download icon in the page header and select Export as Excel. The file is saved asRiskRegister.xlsx and includes:
