Skip to main content
Compare Projects

Overview

The Compare Projects report matches resource assignments between two projects and displays their costs side by side. Each row shows the cost from Project 1, the cost from Project 2, and the calculated difference, grouped hierarchically by WBS and work package down to the individual resource assignment level. Use this report to benchmark a new project estimate against a completed project, compare a baseline against a revised estimate, or analyze cost differences across related projects. URL: /Reporting/CompareProjects/Index

Prerequisites

  • Select two projects using the project filter dropdowns. The grid does not load until both are selected.

Filters

FilterWhat It Controls
Project 1The first project to include in the comparison
Project 2The second project to compare against (can be the same project)
Currency DivisorDisplay values in base dollars, thousands (K), or millions (M)

Reading the Grid

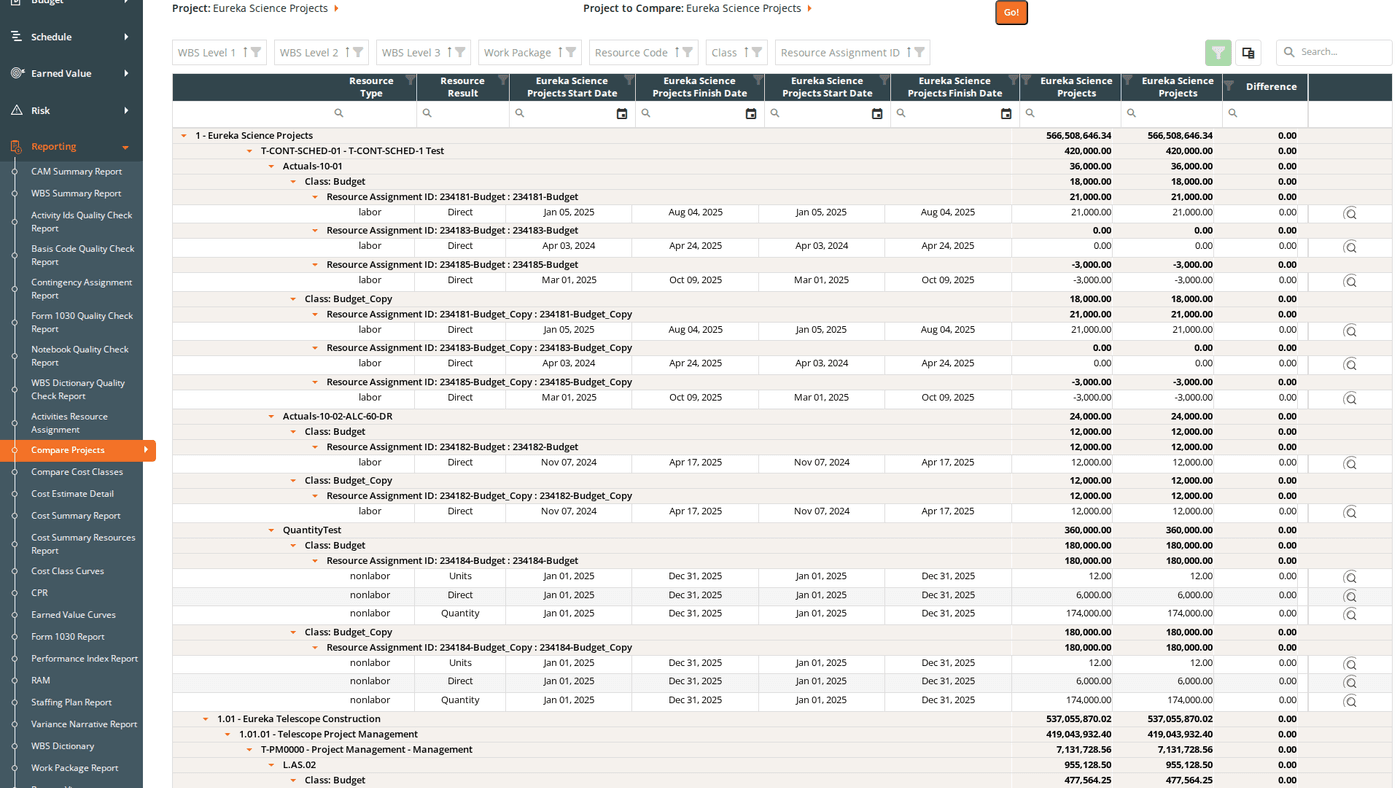

Hierarchy

The grid is organized hierarchically:
WBS Level 1
  └── WBS Level 2
        └── WBS Level 3 (and deeper levels if configured)
              └── Work Package
                    └── Resource Code
                          └── Cost Class
                                └── Resource Assignment
The grid loads collapsed by default. Expand rows by clicking them, or use the Expand All Groups / Collapse All Groups link above the grid. Each group row shows summed totals for all three cost columns, so you can compare costs at any level of the hierarchy without expanding to the detail.

Columns

Fixed identifier columns (left side):
ColumnDescription
WBS Level 1–3WBS group columns, visible by default. Each level also has hidden Number-only and Description-only sub-columns available via the column chooser.
WBS Level 4–9Hidden by default; add via the column chooser
Work PackageWork package group column
Resource CodeResource code group column
ClassCost class group column. Default filter: Budget: only Budget cost class data appears on initial load. Clear or change this filter to see other cost classes.
Resource Assignment IDResource assignment group column
Resource Code DescriptionHidden by default; add via the column chooser
Resource Assignment DescriptionHidden by default; add via the column chooser
Resource TypeThe type classification for this resource
Resource ResultThe result type (e.g., Labor Hours, FTEs, Travel)
[Project 1] Start DateStart date for the Project 1 resource assignment. Column header shows the actual project name.
[Project 1] Finish DateFinish date for the Project 1 resource assignment
[Project 2] Start DateStart date for the Project 2 resource assignment
[Project 2] Finish DateFinish date for the Project 2 resource assignment
Cost comparison columns (right side):
ColumnDescription
[Project 1 Name]Cost from Project 1. Column header shows the actual project name plus the divisor label (e.g., ($K)).
[Project 2 Name]Cost from Project 2. Column header shows the actual project name.
DifferenceProject 2 minus Project 1. A negative value means Project 2 is lower than Project 1.
ViewOpens the time-phased RA Detail pivot grid for this row (see below)
The Class column has a default filter of Budget. If you need to compare other cost classes (Revised, Actuals, etc.), clear or change the Class filter in the filter row.

Time-Phased RA Detail

Click the View button on any resource assignment row to open the RA Detail pivot grid. This shows the cost comparison broken down by period. Modal header:
Resource Assignment ID: [ID from Project 1]
Compared to Resource Assignment ID: [ID from Project 2]
Pivot structure:
  • Rows: Resource Assignment ID and Resource Result type (tree layout; expand a Resource Assignment ID to see its result types)
  • Columns: Fiscal Year → Quarter → Month (hierarchical; expand a year to see quarters, expand a quarter to see months)
  • Values: Cost for each period
  • Subtotals and grand totals: Shown for both rows and columns
Use this view to pinpoint exactly when in the project timeline costs diverge between the two projects.

When to Use This Report

Use Compare Projects when you need to:
  • Benchmark estimates: compare a new project’s budget against a completed project of similar scope to validate reasonableness.
  • Baseline vs. current: compare an original baseline snapshot (stored as a separate project) against the current working estimate.
  • Cross-project analysis: identify which work packages or resource codes account for cost differences between two related projects.
  • Find timing of divergence: use the View button to drill into the monthly breakdown and find when the two projects’ costs first diverge.

Saved Views

Compare Projects supports named saved views that preserve your column layout, grouping, and filter settings. Use the view selector in the toolbar to save and reload your own named views.
When viewing a system view, the message “Currently viewing a system view. Changes will not be saved.” appears at the top right of the grid.

Grid Features

FeatureDescription
Expand/Collapse All GroupsLink above the grid. Toggles all group rows at once.
Column chooserAdd hidden columns: WBS Level 4–9, WBS Number/Description sub-columns, Resource Code Description, Resource Assignment Description
Search panelFree-text search across all visible columns
Filter rowPer-column filter inputs; click Apply Filters to apply
Header filterClick any column header for value-based filtering
Filter panelShows active filter criteria and allows clearing them
Group panelDrag columns to add additional grouping levels
Context menuRight-click a group row to expand or collapse it individually

Exporting

Click the Download icon and select Export as Excel. The file is saved as CompareProjects.xlsx with the grid data on a sheet named Compare Projects.
